Updating and calculating the progress rate (percent done)
Basic method for updating the progress rate

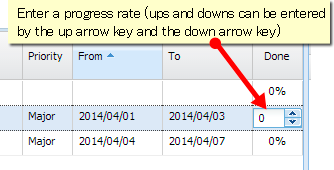

Click % Done to open Edit mode. Then you can either click the up/down arrows or directly enter a value.
![](../__attachments/434372615/050a.png?inst-v=e7cfb899-2364-4b8c-bb82-56cd5c2b91e4)
However you cannot edit the progress rate for:
A project or version
Issues in gray color
Auto-calculating parent issue progress rate

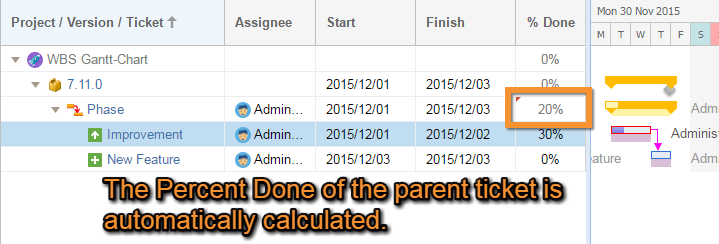

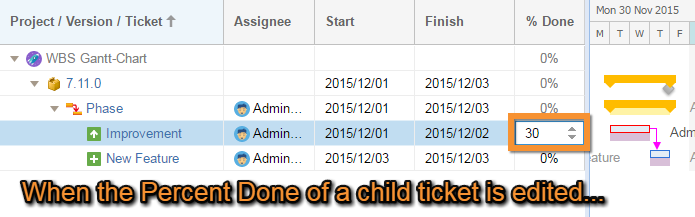

You may want to synchronize the progress rate between parent and child issues. This would mean, for example, that when the progress rate of a child issue is 100%, the parent issue's progress rate will also be 100%. You can do this with Auto-calculate percent done.
![](../__attachments/434372615/blog11-11e.png?inst-v=e7cfb899-2364-4b8c-bb82-56cd5c2b91e4)
![](../__attachments/434372615/blog11-12e.png?inst-v=e7cfb899-2364-4b8c-bb82-56cd5c2b91e4)
The calculation of the progress rate is based on time spent and duration. For example
Issue A has a duration of 1 day with 100% done
Issue B has a duration of 2 days with 50% done
The total progress rate of parent issue would be:
(100% * 1 day + 50% * 2 days) / (1 day + 2 days) = 66% (Decimals are rounded down)

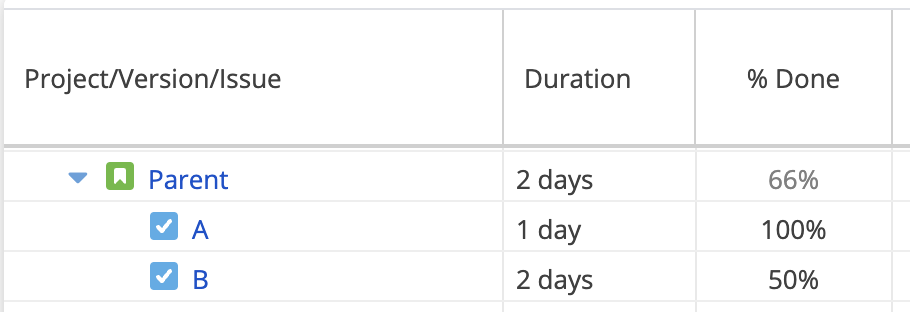

![Screenshot 2024-05-10 at 9.55.14.png](../__attachments/434372615/Screenshot%202024-05-10%20at%209.55.14.png?inst-v=e7cfb899-2364-4b8c-bb82-56cd5c2b91e4)
There is a special case.
The progress rate of the parent ticket is calculated as 100%
However, there is a child ticket with a blank duration and progress rate < 100%
In this scenario, the parent's progress rate will be adjusted to 99%

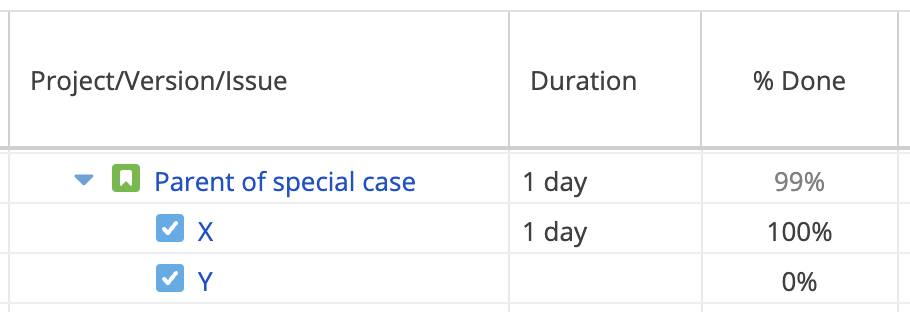

![Screenshot 2024-05-10 at 10.10.50.png](../__attachments/434372615/Screenshot%202024-05-10%20at%2010.10.50.png?inst-v=e7cfb899-2364-4b8c-bb82-56cd5c2b91e4)
Additional Help
If you have any questions please feel free to ask a member of the Atlassian community!
Add the tag "addon-jp.ricksoft.plugins.wbsgantt-for-jira" when you ask a question.
