Global Calendar settings

Access to global common settings

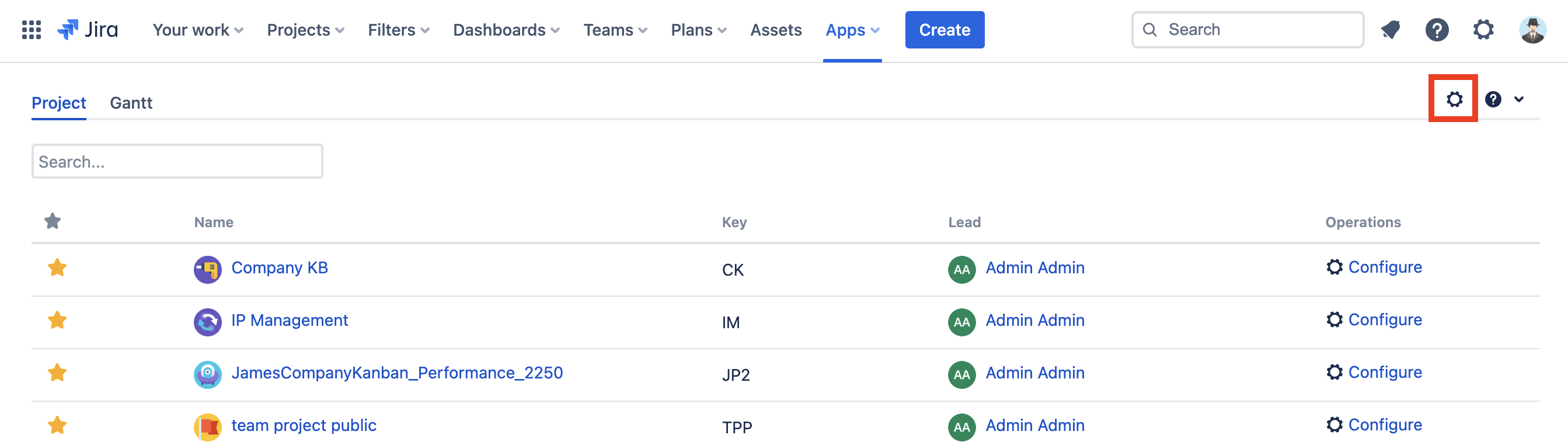

Select Calendar from the sidebar menu

Click the cog icon on the top-right corner

Select Calendar menu

What is the calendar?

Holidays are taken into consideration when project start and finish dates are set. All holidays are managed in WBS Gantt-Chart's holiday calendar.
The calendars set in the Global common setting can be used in all gantts.

Holiday calendar example

This is an example of the holiday calendar, showing two scenarios, A and B, as follows:

Conditions:

Scenario A


Value

1st regular holiday

-

2nd regular holiday

-

Holidays

-

Scenario B


Value

1st regular holiday

Saturday

2nd regular holiday

Sunday

Holidays



Note:  is Monday.

Issue values


Value

Start date



Finish date



Duration

2 days

Operations

Drag-and-drop the Gantt bar so the issue starts on

Results

Scenario A

This scenario does not have holidays, so the issue values are as follows:


Value

Start date



Finish date



Duration

2 days

Scenario B

In this scenario,  ,  , and  will not be counted since they are defined as holidays.


Value

Start date



Finish date



Duration

2 days

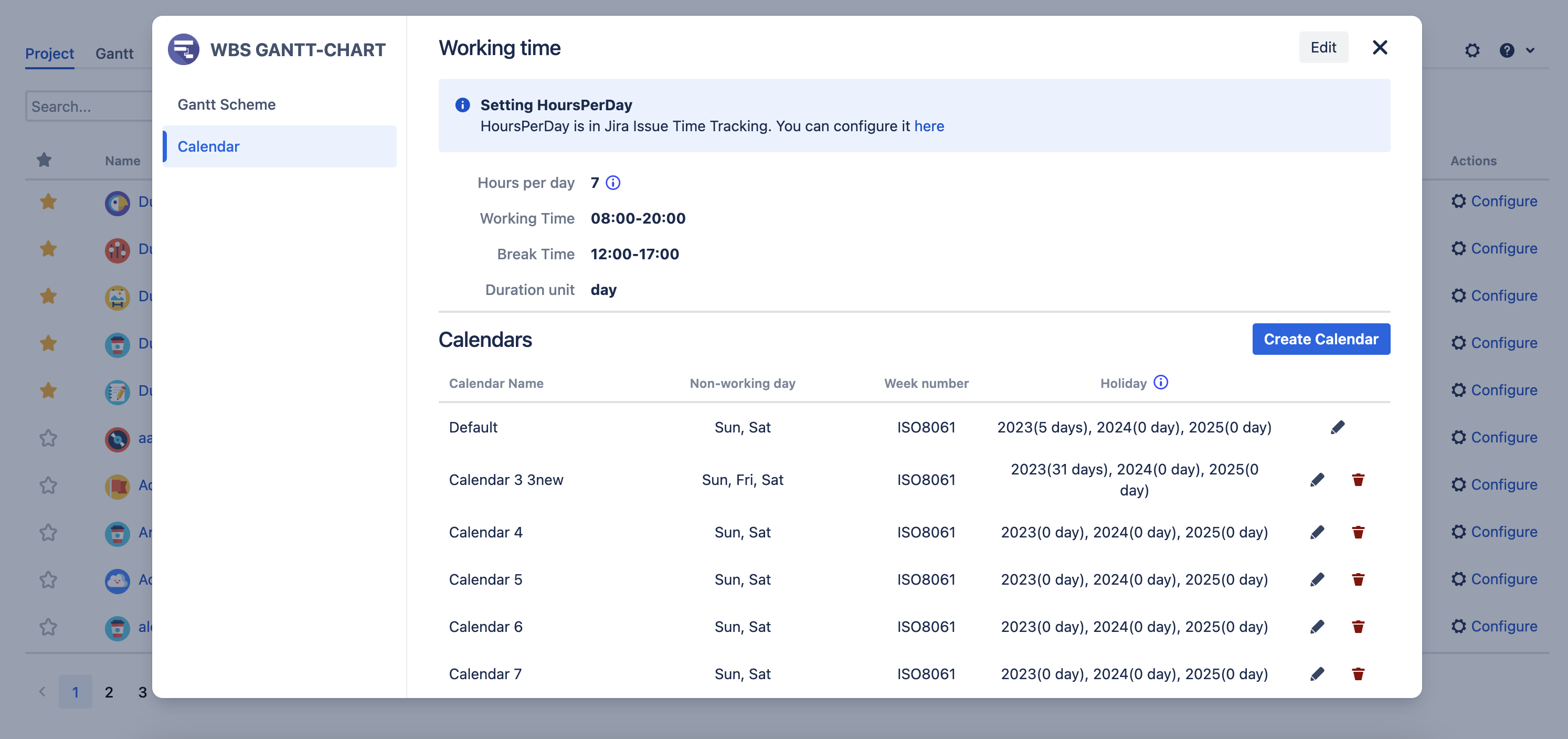

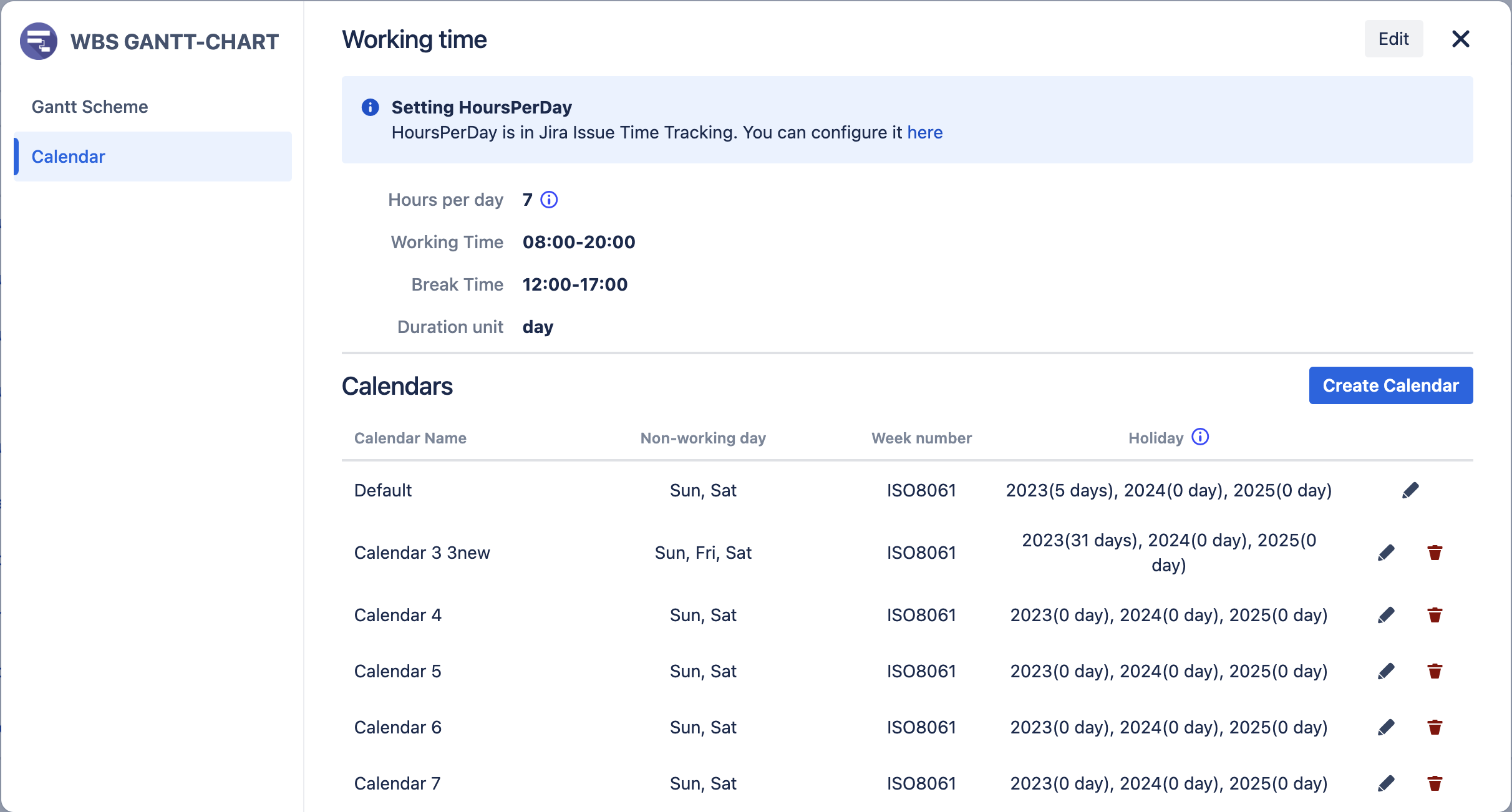

Calendar list page

Required permissions

Action in Calendar setting

Required Permission

Edit Working time

Jira Administrator

Create calendar

Any users

Edit

Delete

Any users, but

  • Do not allow delete Default Caledar

  • Do not aloow delete the calendars that are being used in any Gantt or Scheme settings

Working time setting

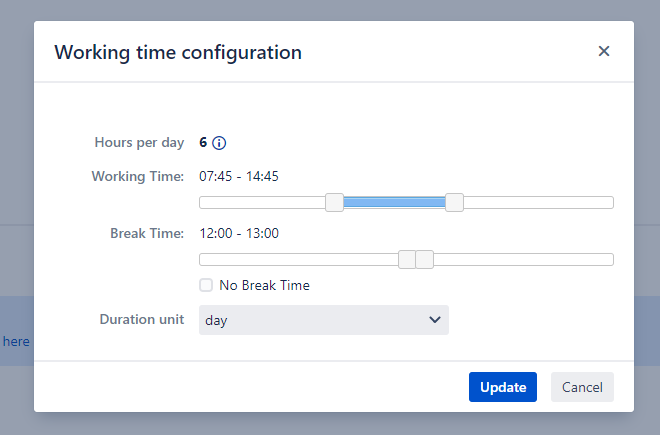

Settings

Hours per day

The number of working hours per day. This follows Jira's global settings.

Working Time

The length will be determined according to the Hours per day and Break Time settings.

  • If the Start time of this setting is the same as the Start time of the task, the time will be omitted and only the date will be displayed in the Start column of the WBS/Gantt Chart view.

  • If the Finish time of this setting is the same as the Finish time of the task, the time will be omitted and only the date will be displayed in the Finish column of the WBS/Gantt Chart view.

Break Time

Set the time to be treated as a break in the work hours.

Duration unit

This setting is used to set the display unit of the Duration column displayed in the WBS/Gantt-Chart view.

When "day" is selected, the duration of the task will be displayed in days according to the settings of Hours per day, Working Time, and Break Time.

Example

Calendar

Yes / No

1st regular holiday

Saturday

2nd regular holiday

Sunday

Holidays

-

Working time

items

value

Hours per day

8

Working Time

09:00 - 18:00

Break Time

12:00 - 13:00

Task

items

value

Start

09:00

Finish

12:00

  • The duration of this task will be "27 hours" if the duration unit is "hour".

  • The duration of this task will be "3.375 days" if the duration unit is "day".

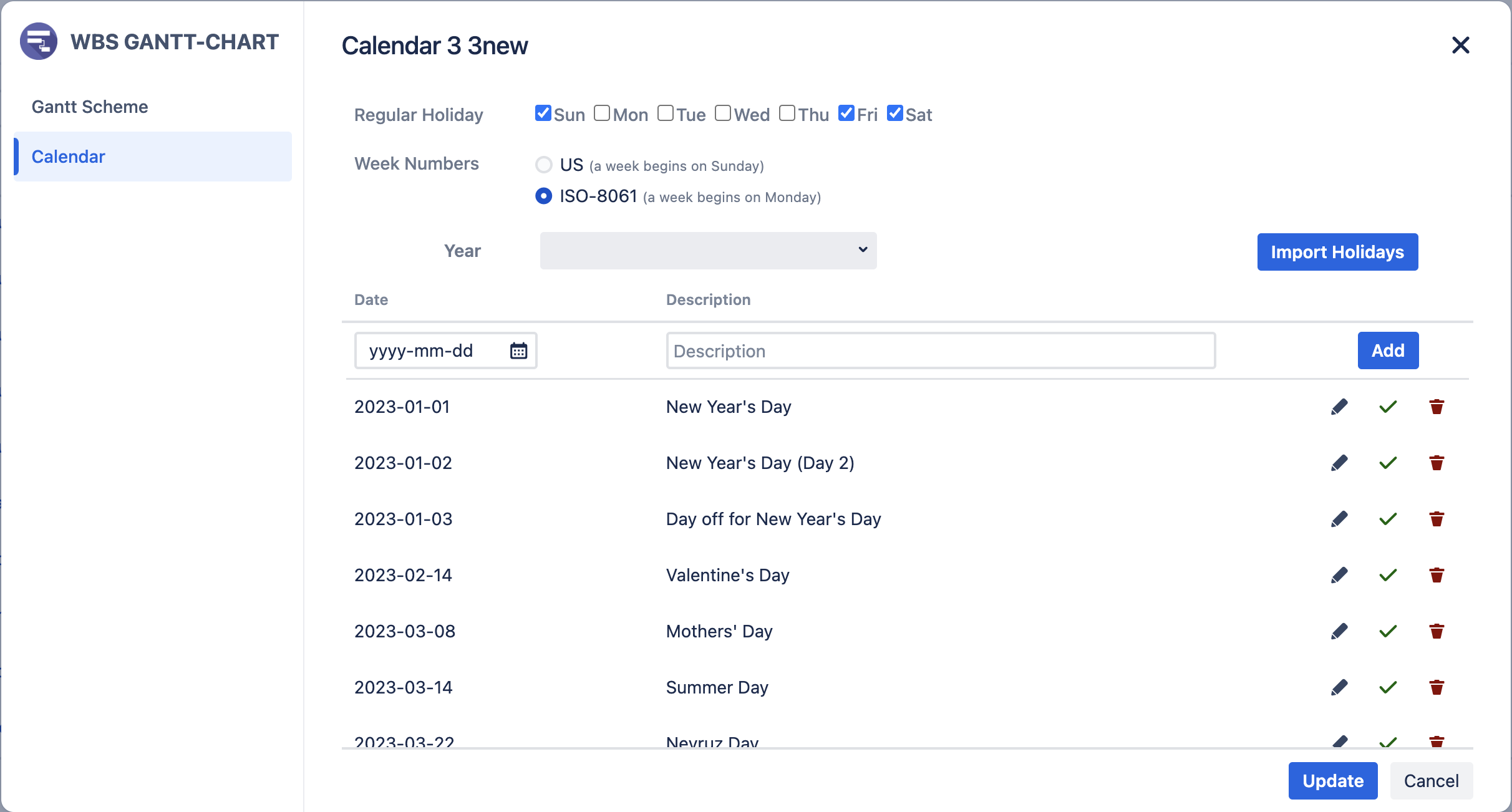

Calendar detail page

Screenshot 2024-01-10 at 10.46.19.png

Regular holiday

Check the non-working days in the week

Week Numbers

This item sets the week number and the starting day of the week.

If US is selected, the week in the Gantt chart is displayed starting on Sunday, and the week number is also displayed in US style.

If ISO-8601 is selected, the week in the Gantt chart is displayed starting on Monday, and the week number is also displayed in the ISO-8601 style.

Year

Filter to show the holiday in the years from Holiday List

Holiday List

This is a list of the dates you have registered as holidays.

Import Holidays

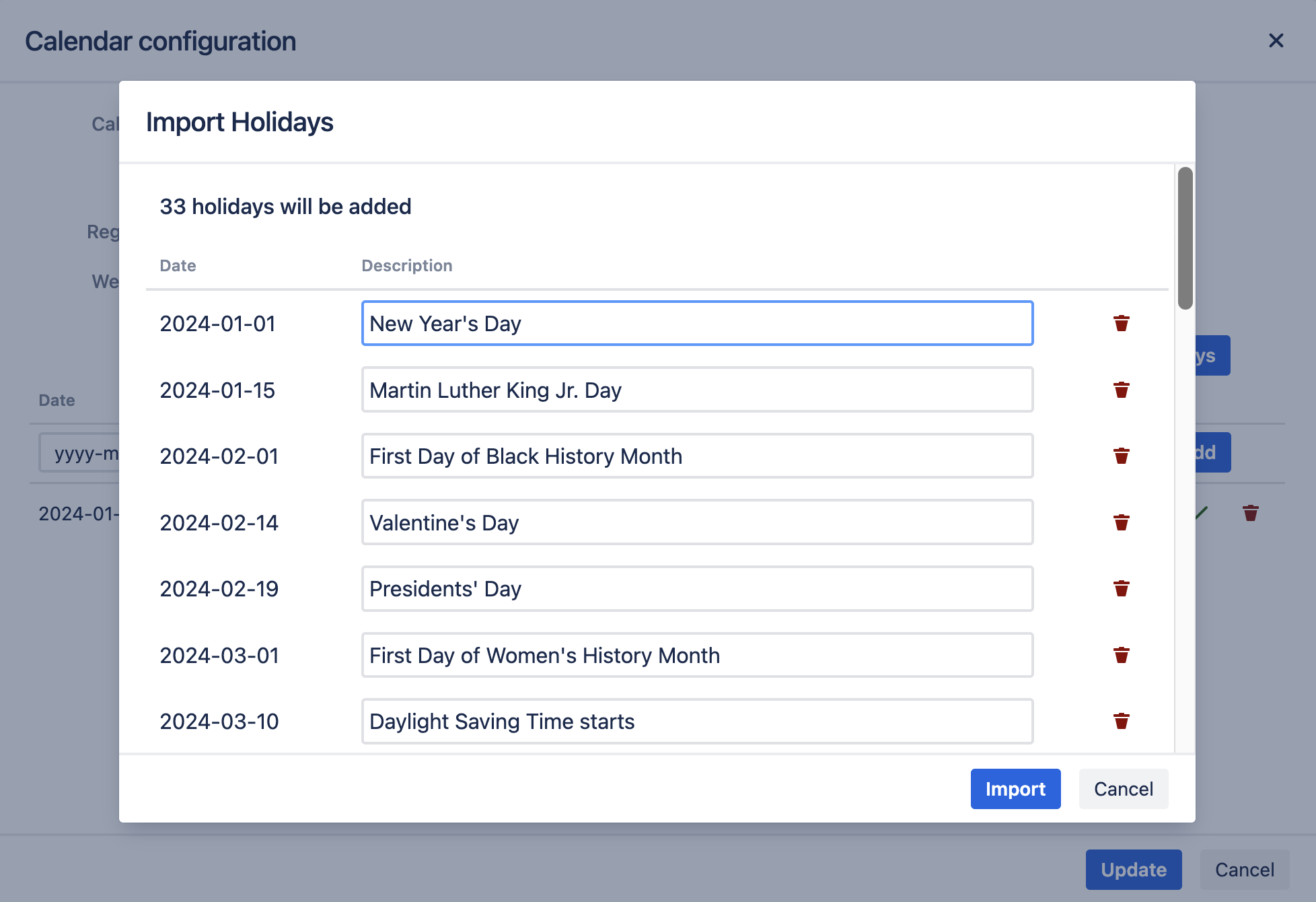

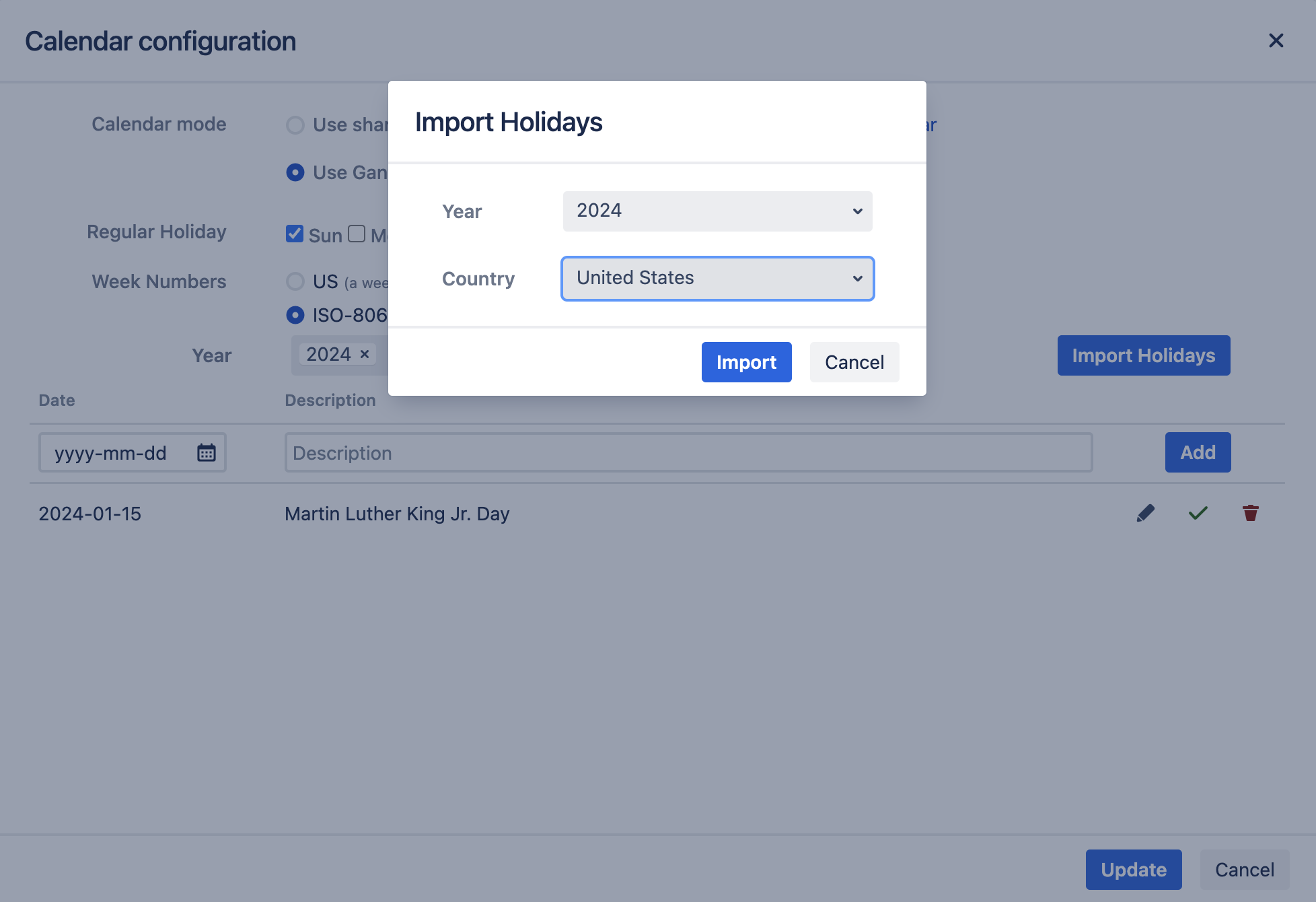

Choose Year and Country to import the public holidays from Google Calendar

Screenshot 2024-01-10 at 10.40.27.png
Screenshot 2024-01-10 at 10.40.47.png

Additional Help

If you have any questions please feel free to ask a member of the Atlassian community!

Add the tag "addon-jp.ricksoft.plugins.wbsgantt-for-jira" when you ask a question.

Ask the community

JavaScript errors detected

Please note, these errors can depend on your browser setup.

If this problem persists, please contact our support.
